Yonge Street Reconstruction
Project Status: Substantially Completed
Estimated Completion: Spring 2026
Update Posted December 12, 2025
All temporary works (curb ramping and asphalt sidewalks) are completed and Yonge Street is fully open. The electrical contractor will be at Eighth and Yonge working over the next two weeks to expedite getting the light installed and turned on. Mid-Pen Transit’s Midland Route remains on detour until the traffic lighting is completed.
In the spring, the contractor will be back removing the temporary works and fixing any deficiencies before paving the surface asphalt on the road and pouring concrete sidewalks. Subscribe to news & notices to stay tuned!
Yonge Street underwent reconstruction between Second Street and Norene Street, King Street to Second Street, and from Norene Street to County Road 93. The project started in May 2025 and is anticipated to be fully complete Spring 2026. This project includes:
- New sanitary sewer replacement and associated services.
- New watermain replacement and associated services.
- New barrier curb and gutter, restoration of all disturbed areas including driveways, topsoil, sod and surface elements.
- New Asphalt from King Street to County Road 93.
This project included an interruption to transit service with a detour on Yonge Street.
Yonge Street Reconstruction Phases
| Construction Phases | Estimated Timeframe |
|---|---|
| Reconstruction of Yonge St between Second St and Fourth St | May 2025 to July 2025 |
| Resurfacing of Yonge St between Norene St to County Road 93 | May 2025 to August 2025 |
| Reconstruction of Yonge St between Fourth St and Sixth St | July 2025 to August 2025 |
| Resurfacing of Yonge St between King St to Second St | August 2025 to October 2025 |
| Reconstruction of Yonge St between Sixth St and Norene St | August 2025 to November 2025 |
| Surface works on Yonge Street between Seventh Street and Norene Street | April 2026 to May 2026 |

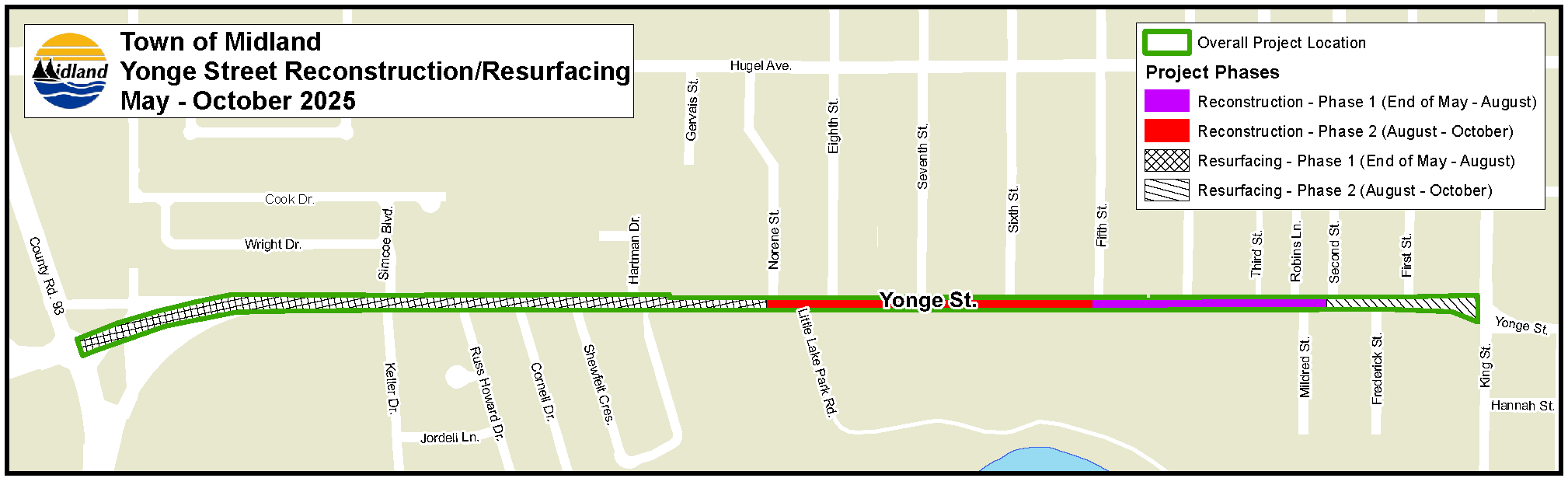

Project Area

Yonge Street Reconstruction Notices
A paper notice was delivered to properties within the affected area on Yonge Street. The notice outlines information for property owners and potential affected services. View the full notice delivered May 2025.
A paper notice was delivered to affected residents for a temporary water shut off. View the full notice here.
Questions about construction
If you have any questions or comments about the Yonge Street Reconstruction project contact Trevor or Chris using the contact information below. Damages should be reported to the contract administrator or contractor as soon as possible.
| Tatham Engineering Limited | Maacon Construction Corporation | Town of Midland |
|---|---|---|
|
Trevor Stapleton Contract Administrator 115 Sandford Fleming Drive, Suite 200 Collingwood, Ontario L9Y 5A6 705-717-0550 tstapleton@tathameng.com |
Zac Nicol Public Relations Officers 45 Robillard Drive Penetanguishene, Ontario L9M 1G9 519-372-5966 Zac@maacon.com |
Bailee Yasher Senior Project Manager 575 Dominion Ave Midland, Ontario, L4R 1R2 705-526-4275, ext. 2207
|
